Langfang Central Hospital Construction Project

Langfang Central Hospital Engineering Project

Project Overview

The Langfang Central Hospital project is situated in the Science and Technology Valley Park, northwest of Langfang City. Covering an area of 240 acres, the facility boasts a total construction area of approximately 156,000 square meters, with 1,000 beds and classification as a tertiary Grade A hospital. The total investment in the project amounts to about 1 billion yuan.

This project stands as the largest government-funded public welfare initiative in Langfang City’s history. Notably, it is also the first government investment project in Langfang to implement a project management company model, with Ruihe Anhui Project Management Group Co., Ltd. overseeing management.

Application Achievements

Cost Reduction

Utilizing BIM in project contract planning integrates revenue, cost, and contract data, significantly enhancing contract and cost control. This approach refines control details and effectively reduces project management time and labor expenses.

Shortened Construction Period

By combining BIM models with overall project progress control, the project manages progress in flow segment dimensions. This visual management introduces innovative ideas to on-site personnel, substantially saving time spent on daily progress management.

Talent Development

The project incorporates BIM concepts into daily management, fostering a team of versatile professionals who embrace BIM principles and possess BIM implementation skills, establishing a strong foundation for the company’s long-term growth.

Brand Enhancement

The project was awarded third prize in the 2014 Longtu Cup BIM Competition, elevating the company’s brand image within the industry.

Results Presentation

On-site Progress Control

Langfang Central Hospital Engineering Project

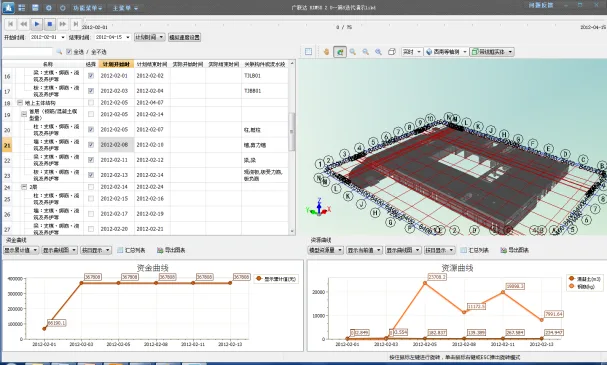

A flow section is drawn based on the on-site zoning map and linked with scheduled tasks, allowing it to be viewed as part of the overall plan. This forms the essential basis for associating physical progress with scheduled activities.

Langfang Central Hospital Engineering Project

The model’s status can be reviewed within any planned interval at any time, displaying real-time data such as funding and resource information to simulate on-site work conditions effectively.

Construction Guidance

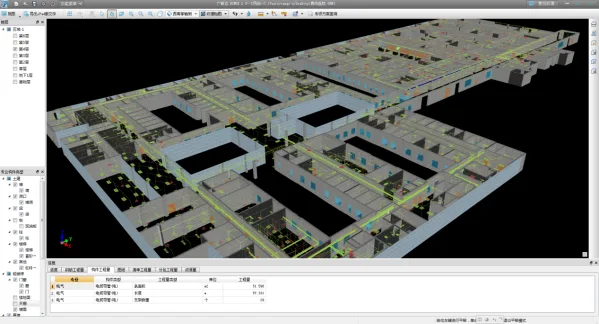

Users can filter the model by floors, specialties, and flow segments to display necessary information. This reflects the multidimensional engineering quantities within the model and guides on-site construction activities.

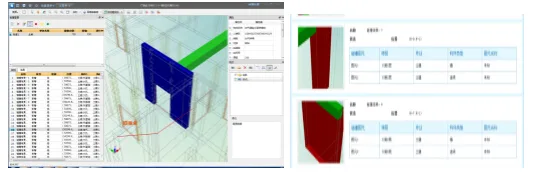

Langfang Central Hospital Engineering Project

Pilot Saving Annotations

Annotations can be added through box selection, offering a model-based reference for construction that can be saved and viewed anytime.

Langfang Central Hospital Engineering Project

3D Dynamic Roaming

Real-time 3D roaming allows users to explore building details and pipeline integration at any section, enhancing visualization and understanding.

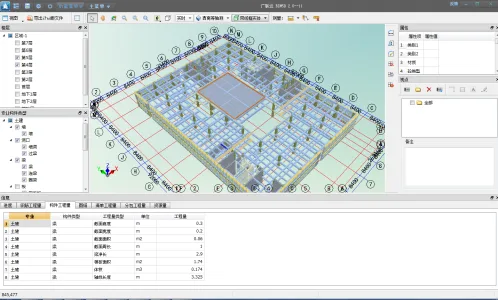

Langfang Central Hospital Engineering Project

Business Applications

1. By linking the model with budget and subcontracting costs, the model contains actual price information, providing a reliable source for early investment estimates and later settlements.

2. Contract planning, subcontracting maintenance, and three-way comparison calculations are employed to control project costs throughout pre-, during-, and post-project phases.

Langfang Central Hospital Engineering Project

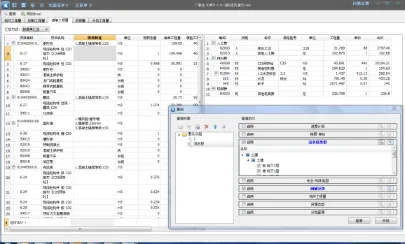

Quantity Inquiry

Langfang Central Hospital Engineering Project

The system offers advanced multi-dimensional query functions, facilitating on-site feeding, material supply, subcontracting settlements, and timely calculation of design change costs.

Collision Check

Multi-disciplinary drawing issues are identified early, providing comprehensive and visual inspection reports to avoid conflicts during construction.

Langfang Central Hospital Engineering Project

Customer Feedback

1. The deep integration of scheduling, cost, and BIM models enables project teams to manage planning, simulate finances and resources using Guanglian Da BIM5D software, significantly saving engineers’ time.

2. Simulating weekly construction progress and efficiently managing funds, labor, materials, and machinery reduces the time and effort required by on-site personnel.

3. Querying material quantities at various time or process nodes, and exporting reports, revolutionizes traditional material planning methods, improving efficiency and accuracy.

4. Querying engineering information by specialty allows one person to integrate and review multiple professional quantities, greatly enhancing efficiency and precision while supporting bidding decisions.

xuebim
Follow the latest BIM developments in the architecture industry, explore innovative building technologies, and discover cutting-edge industry insights.
← Scan with WeChat
Like(0) 打赏
BIM WORLD » Langfang Central Hospital Construction Project

Comment Get first!

Must log in before commenting!



BIM World, A Professional BIM Learning Platform

Stay updated on the latest architecture trends and share new building technologies.

Contact UsAbout Us

觉得文章有用就打赏一下小编吧

非常感谢你的打赏,我们将继续提供更多优质内容,让我们一起创建更加美好的网络世界!

支付宝扫一扫

微信扫一扫

Account Login

By signing in, you agree toUser Agreement

Sign Up
